LED Wall Setup Time: What Actually Drives Load-In Speed (Beyond Headcount)

Stage crew carrying truss during outdoor LED stage load-in with road cases

Two rental LED quotes can both say “fast install” and still diverge by hours at the dock. The gap is rarely the pixel pitch on page one. It is unmeasured system friction: awkward locks, heavy cabinets, cases unloaded in the wrong order, power not ready when the wall is, signal mapping improvised under pressure, or a venue that blocks the freight path while the LED crew stands ready.

Our live outdoor festival checklist owns weather, nits, IP, wind, and crew tech habits. Our live rental spare parts post owns what to stock. This post owns only one thing: what actually moves the load-in clock so “fast install” becomes a countable RFQ conversation before the truck rolls.

Quick definitions (clear the name collision)

TermWhat it meansWhat it is not
Setup / load-in timeWall time from first case on the dock to a stable, mapped, content-ready wallNot “cabinets locked” alone – commissioning counts
Build timePhysical assemble + lock + rough cableNot the full show-ready clock
CommissioningPower-up, map, test patterns, brightness/color sanity, content raster checkNot optional “if we have time”
Strike / pack-downReverse build + cable coil + case mapNot free time after doors
Tool-free / quick-lockCabinet-to-cabinet latch designed for hand operation without screwsNot automatic proof of a fast system if cases and power are chaotic
Case pack logicHow cabinets and accessories are ordered in flight cases so unload matches buildNot “everything fits in the truck”
Check-as-you-buildVerify power, data, and locks row by row / section by section instead of waiting for the full wallNot slowing down – it usually prevents late rebuilds
Mounting methodGround stack, flown/hanging, curved, or scenic integrationNot the same labor clock for the same product

Industry language is blunt: more hands do not fix a messy system.

Why this question stays hot for buyers

2026 rental trend writing keeps repeating the same shift: clients still ask about pitch and brightness, but rental companies themselves are buying for setup efficiency, camera performance, transport cost, and power. Labor is expensive; schedules are compressed; saving a few hours on a large production is real money in Europe and North America especially.

Dedicated setup-time explainers frame the clock as a wider system – panel design, mounting method, transport flow, power and signal planning, rigging readiness, access constraints, and preproduction quality – not “crew was too small.” Assembly guides emphasize that the difference between a short build and a long one is often decided before the first cabinet leaves its flight case. Touring posts make the same operational point in different words: know the system, check as you build, correct small faults before they become show faults.

Buyers comparing two “lightweight quick-lock” quotes still need a checklist that turns brochure speed into assumed hours, assumed crew, assumed venue, assumed prep.

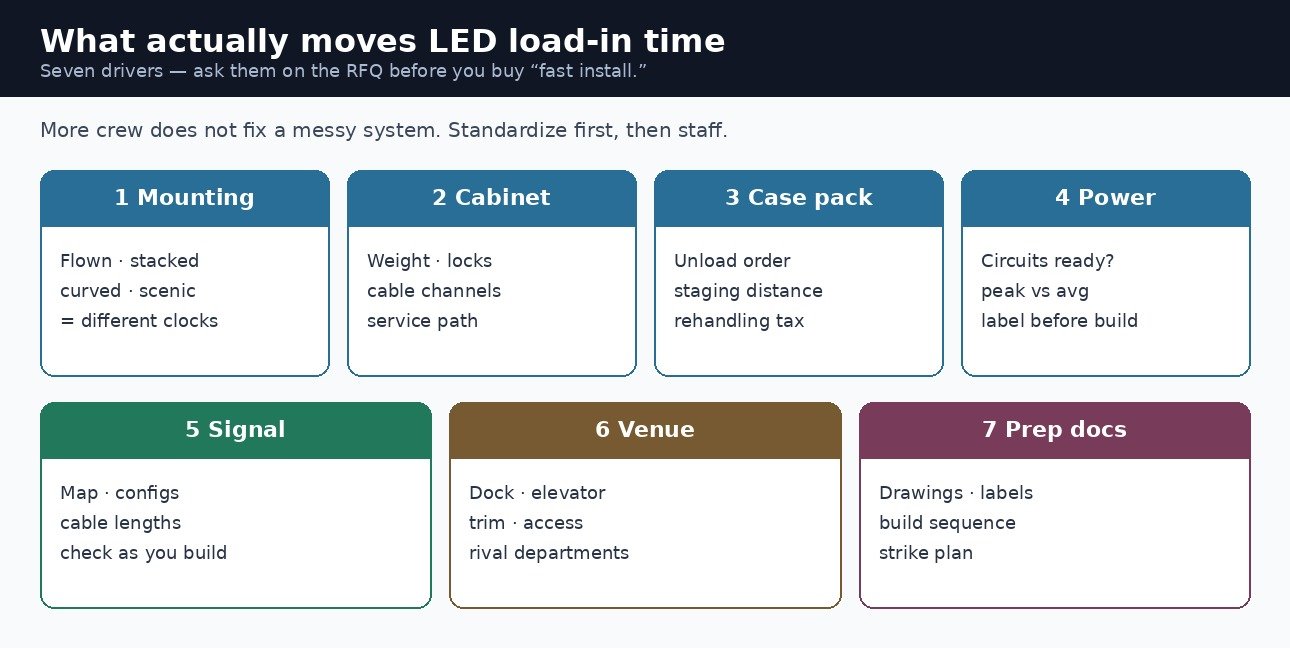

Seven drivers of LED wall load-in time: mounting method, cabinet, case pack, power, signal, venue and prep documents

The seven drivers that actually move the clock

1) Mounting method sets the baseline

A ground-supported wall, a flown wall, a curved wall, and a scenic integration do not share one clock, even on the same product family. Flown work waits on motors, truss, and certified rigging readiness. Stacked work waits on floor flatness, bracing, and depth behind the screen. Curve and creative formats add alignment and angle checks. If the RFQ never names the mount method, “fast install” is an empty adjective.

2) Cabinet mechanics: weight, locks, cable path, service access

Lightweight cabinets and tool-free locks matter because crews handle hundreds of connections on a touring week. Industry assembly guides commonly describe modern rental cabinets with hand-operated quick locks and internal cable channels that reduce rear spaghetti. What matters for the buyer is not a single manufacturer’s “0.5-second lock” marketing line – it is whether your quoted cabinet:

  • has a stated weight band the crew can plan around
  • uses locks that seat fully (partially rotated levers are a classic late-fault)
  • routes power/data so commissioning is not a cable hunt
  • allows fault isolation without tearing down finished rows

Heavy steel-era touring stock and screw-only joins still exist in some fleets. Compare mechanics honestly; do not compare pitch alone.

3) Case pack and unload order (the hidden tax)

If cases arrive in the wrong order, if wall sections stage too far from the build area, or if processing gear arrives after the structure is up, the crew pays in waiting and rehandling. Standardization wins: repeatable cabinet sizes, known case maps, labeled cable lengths, consistent processor workflows. A “fast” cabinet in a random pack order still loses the afternoon.

4) Power readiness

A wall that is locked but waiting on circuits is not done. Peak and average draw, circuit count, distro ownership, and whether house power or show power is the path all belong on the first planning page. Our live peak vs average power post owns the electrical sizing math. Here we only insist: power plan before full build, or commissioning becomes idle time.

5) Signal and mapping prep

Improvised mapping under pressure is a common way to “lose” the last hour even when physical build looked fine. Preload processor configurations where the workflow allows, define the content raster early, label data paths, and keep known-good spare jumpers. Progressive section checks beat a single end-of-build surprise. Dual power / dual data design is a sister topic on our live redundancy post – here the ask is simply: is the signal plan ready before the dock opens?

6) Venue reality beats brochure speed

Tight docks, narrow freight elevators, blocked backstage circulation, unfinished trim height, or a rival department still owning the hang points can stall an efficient product. Temporary-event guidance treats site conditions as part of installation risk and speed. Write venue assumptions on the quote: dock window, elevator size, trim ready-by, who owns house power and house rigging.

7) Preproduction documents

Build drawings, patch plans, case-pack sheets, cable labels, signal-flow diagrams, and venue-specific rigging notes reduce field decisions. The more the team decides before arrival, the less the load-in becomes a debate club.

Traps that look like “fast install”

TrapWhat goes wrongWhat to ask
Brochure speed only“Quick-lock” with no weight, pack, or mount assumptionsName mount method + kg band + lock type + case logic
More crew = fasterCongestion, duplicated work, no sequenceSequence + case order first; then staff the sequence
Build ≠ readyCabinets up, wall dark or unmappedInclude commissioning in the time ask
Locks half-seatedVibration unlock / seam open mid-showVisual + pull check that levers are fully home
Signal after structureRepatch under pressureConfig + map + labeled cables before truck
Power laterIdle wall waiting on circuitsPeak/avg + circuit owner on page one
Venue ignoredProduct ready, dock notDock / elevator / trim / rig ready-by assumptions
Comparing unequal bidsCheap panel wins; labor overrun billed laterNormalize the seven drivers before comparing totals
Guaranteed hours from a PDFThird-party “2-3 hours for 6×4 m” treated as your PO promiseTreat published ranges as heuristics; write your crew model

Honesty on numbers: some 2026 assembly guides publish example crews and hour bands for specific cabinet sizes (for example, a few-person crew completing a mid-size 500×500 wall in a couple of hours under good conditions). Those are illustrative industry heuristics, not an SFxDisplay guarantee for every venue. Your clock depends on mount method, venue, prep, and fault rate.

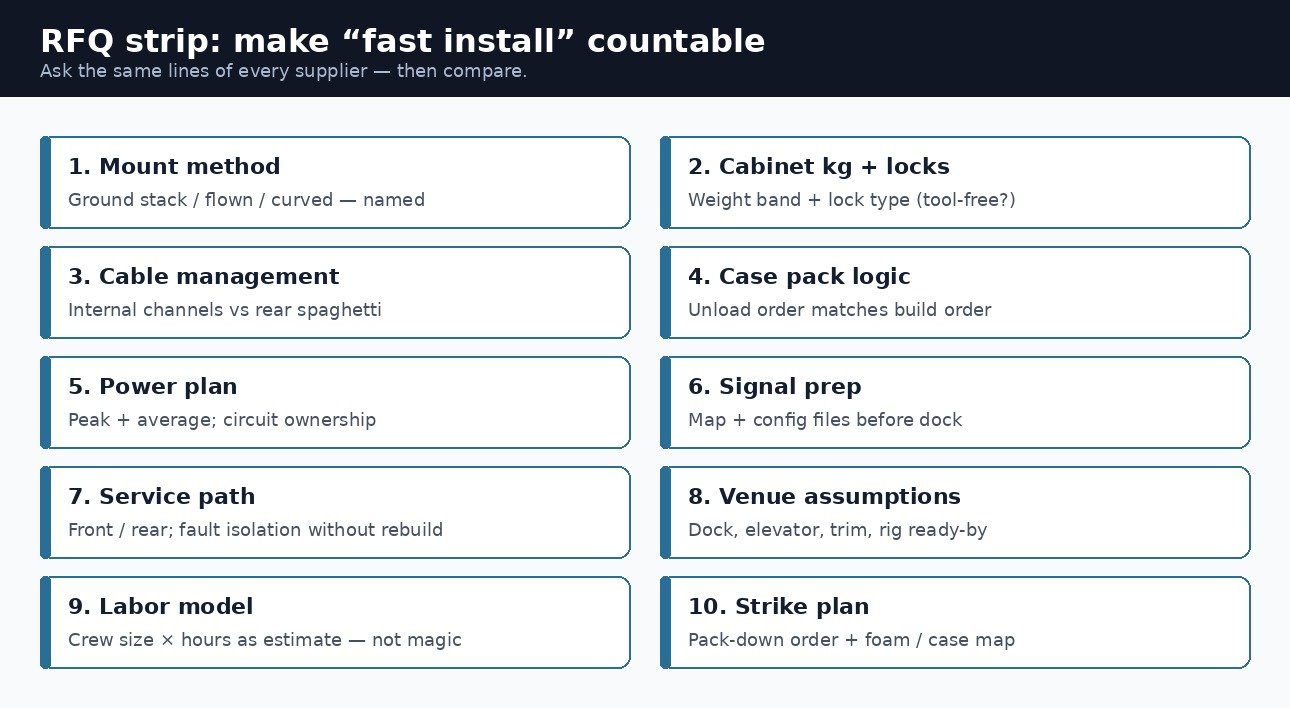

LED wall RFQ checklist to make fast install countable: mount method, cabinet weight and locks, cabling, case pack, power, signal, service path, venue, labor and strike plan

How this post divides labor with sister articles

Sister topicWhat it ownsWhat this post owns
Outdoor festival checklistWeather, nits, IP, wind, generator habitsSpeed drivers that still apply indoors
Spare parts / hot-swapWhat to stock and when hot-swap mattersHow fast you can reach and swap without rebuild
Front vs rear serviceAccess route to the partWhether service forces teardown of finished rows
4K weight / hangingStructure, hang math, crew handling fatigueWeight as one input to setup speed
Power & signal redundancyFailover designPrep and topology so commissioning is not chaos
Peak vs average powerElectrical sizing numbersPower readiness on the load-in clock

RFQ checklist (copy onto the PO)

Ask every supplier the same lines so “fast install” is comparable:

  1. Mount method – ground stack, flown, curved, or scenic – named on page one.
  2. Cabinet weight band – kg per cabinet (and per m² if quoted that way).
  3. Lock type – tool-free quick-lock or screw; how many locks per side; how crew verifies full seat.
  4. Cable management – internal channels / blind-mate plates vs rear jumpers only.
  5. Case pack logic – does unload order match build order? Who owns the case map?
  6. Power plan – peak and average assumptions; circuit count; who owns distro.
  7. Signal prep – mapping files, processor config ownership, spare known-good data jumpers.
  8. Service path – front / rear; can a dead module be swapped without reopening finished rows?
  9. Venue assumptions – dock window, elevator, trim height, rig ready-by, house vs show power.
  10. Labor model – proposed crew size × hours as an estimate, including commissioning – not a magic slogan.
  11. Strike plan – pack-down order, foam protection, cable coil standard.
  12. Check-as-you-build – will sections be powered/tested progressively?
  13. Do not compare panel price alone until the seven drivers and venue assumptions match.
  14. Do not treat a third-party “X hours” PDF line as your contractual guarantee without writing venue and prep assumptions.

Related reading (live SFxDisplay)

PostWhat it owns vs this article
Outdoor festival checklistWeather, nits, IP, wind, generator, crew tech
LED rental spare parts / hot-swapInventory math + hot-swap verify
Front vs rear serviceHow you reach the part
Power & signal redundancyFailover paths
Peak vs average powerElectrical sizing
LED video wall cost 2026Panel vs turnkey CapEx framing
How to chooseBroad selection framing
Rental seriesProduct starting point after the clock assumptions are clear
ContactQuote with mount method + venue + prep asks

SFxDisplay honest boundary

We build and quote rental and fixed LED systems for buyers who need clear load-in language, not a sticker that says “fast.” We will help you list mount method, cabinet weight and locks, case-pack expectations, power and signal prep, venue assumptions, and a crew-hour estimate that includes commissioning when you ask. We will not invent a public guarantee in this post that every SFxDisplay wall finishes in a fixed number of hours. We will not pretend more crew always shortens a chaotic sequence. We will not push named competitor panel brands. If your show is flown overnight, dock-limited, curved, or camera-critical, say so early – that changes the system design more than it changes the brochure tagline.

Browse rental series and how to choose an LED display, then paste the checklist onto the PO. Or contact SFxDisplay – WhatsApp +86 150 1911 0341 · molly@sfxdisplay.com.

Bottom line

“Fast install” only means something when the system is named. Mount method, cabinet mechanics, case-pack order, power readiness, signal prep, venue access, and check-as-you-build move the clock more than headcount alone. Treat third-party hour bands as heuristics. Normalize the RFQ lines before you compare totals. Keep weather on the festival checklist; keep spare math on the spare-parts post; keep load-in honesty here – so the wall you buy is the wall your crew can actually put up on time.
